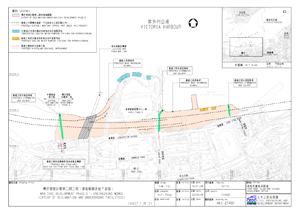

Wan Chai development phase II, engineering works
Project Number:
7677CL
Brief Description of Project Scope:
The scope of the project comprises:
- reclamation of the seabed in Wan Chai North and North Point to form a total of about 12.7 ha of land, including construction of about 1.57 km of seawall;
- construction of precast box structures spanning over the existing Mass Transit Railway (MTR)Tsuen Wan Line;
- construction of ground level roads of about 0.7 km in total length, modification of existing roads for connection with the slip roads of the proposed Trunk Road, and some other road junction improvement works;
- extension of a dual two-lane primary distributor, Road P2, and realignment of the existing Convention Avenue and Hung Hing Road, of about 1.0 km in total length;
- relocation of a public transport interchange (PTI) at Expo Drive East to combine with an existing PTI at Wan Chai North;
- construction of a footbridge of about 180 m in length along Wan Shing Street;
- construction of three pedestrian landscaped decks to the west of Hong Kong Convention and Exhibition Centre (HKCEC), the north of the Wan Chai North PTI and the north of Victoria Park;
- construction of stormwater box culverts of about 1.17 km in total length in Wan Chai North and North Point and the associated hinterland drainage improvement works;
- reprovisioning of existing waterfront facilities including cross harbour water mains, submarine sewage outfall pipelines, ferry piers, cooling water pumping systems and a salt water pumping station;
- construction of associated footpaths, roadside amenities, stormwater drainage works, sewerage works and landscaping works; and
- implementation of environmental mitigation measures, and an environmental monitoring and audit (EM&A) programme for the works mentioned above.
Project Office in Civil Engineering and Development Department:
South Development Office (Enquiry: 3842 7062)
Consultant:
AECOM Asia Company Limited
Approved Project Estimate:
$4.643 billion
Related Website:
http://www.wd2.gov.hk
Current Progress:
The construction of the West Landscaped Deck at the west of Hong Kong Convention and Exhibition Centre and other associated works commenced in mid-2020 and anticipated to be completed by 2025.
Contract:
Contract No. HK/2009/01
|
Scope: |
The works mainly include land formation and construction of the Central-Wan Chai Bypass tunnel at the water channel in between the two phases of Hong Kong Convention and Exhibition Centre and other associated works. |
Commencement Date: |
30 December 2009 |
Completion Date: |
May 2016 |
Contract Sum: |
$2.314 billion |
Contractor: |
Chun Wo - Leader Joint Venture |
Contract No. HK/2009/02
|
Scope: |
The works mainly include land formation and construction of the Central-Wan Chai Bypass at Wan Chai East and other associated works. |
Commencement Date: |
28 January 2010 |
Completion Date: |
December 2018 |
Contract Sum: |
$3.359 billion |
Contractor: |
Chun Wo - CRGL Joint Venture |
Contract No. HK/2012/08
|
Scope: |
The works mainly include land formation and construction of the Central-Wan Chai Bypass at Wan Chai West and other associated works. |
Commencement Date: |
31 January 2013 |
Completion Date: |
November 2018 |
Contract Sum: |
$3.350 billion |
Contractor: |
China State – Build King Joint Venture |
Contract No. HK/2010/06
|
Scope: |
The works mainly include land formation and construction of the Central-Wan Chai Bypass over MTR Tsuen Wan Line tunnel |
Commencement Date: |
20 January 2011 |
Completion Date: |
July 2013 |
Contract Sum: |
$705 million |
Contractor: |
Gammon - Leader Joint Venture |
|
Contract No. SD/2019/03
|
Scope: |
The works mainly include construction of the West Landscaped Deck at the west of Hong Kong Convention and Exhibition Centre and other associated works |
Commencement Date: |
8 July 2020 |
Completion Date: |
2025 |
Contract Sum: |
$279 million |
Contractor: |
Kin Chiu – China Railway First Group Joint Venture |
Environmental Monitoring and Audit Information:
http://www.wd2-cwb.com/
Other Related Information:
