Kai Tak development – infrastructure works for developments at the southern part of the former runway

Project Number:

7711CL

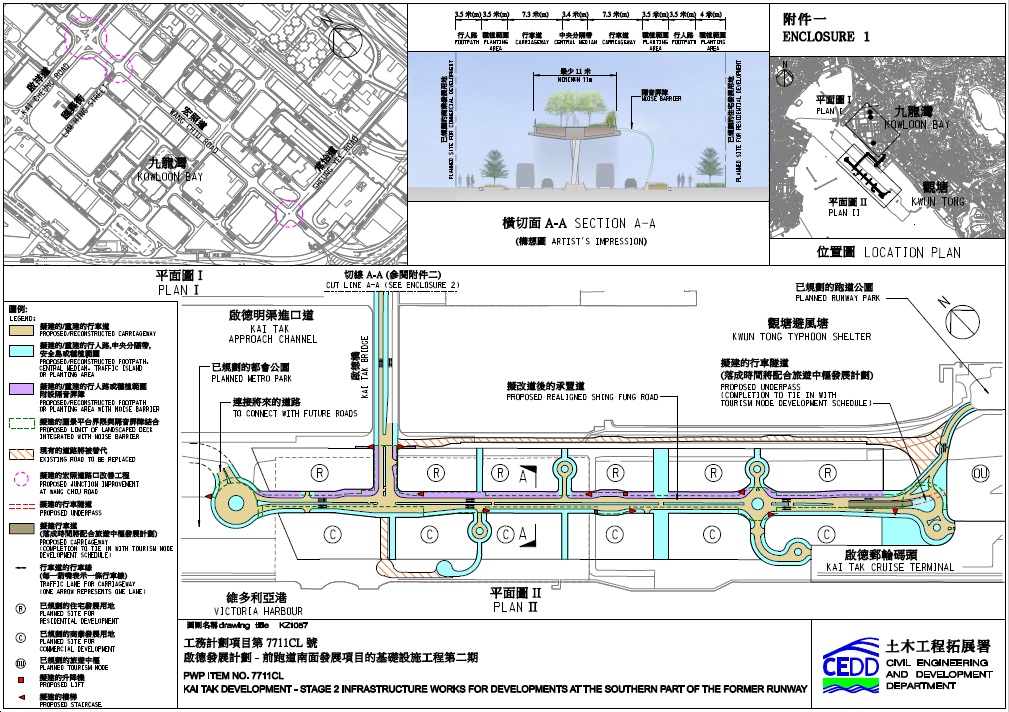

Attachment 1Attachment 2

Brief Description of Project Scope:

The scope of Stage 2 comprises:

  1. construction of the following items of works mainly located at the former runway –
    (i) realignment and widening of the existing single 2-lane Shing Fung Road to form a dual 2-lane distributor road of about 1.4 kilometres (km) long;
    (ii) associated single 2-lane roads (including a vehicular underpass) with a total length of about 0.6 km branching off from the realigned Shing Fung Road to the sites along the road;
    (iii) an elevated landscaped deck with lifts and staircases of about 1.4 km long with minimum 11 metres (m) in width above the realigned Shing Fung Road serving as part of a semi-enclosure noise barrier and also as a public open space; and
    (iv) roadside noise barriers with a total length of about 1.1 km long alongside the realigned Shing Fung Road and integrated with the elevated landscaped deck;
  2. upgrading of the existing single 2-lane carriageway of about 0.3 km long on Kai Tak Bridge to a dual 2-lane carriageway;
  3. improvement to three existing road junctions along Wang Chiu Road at its junctions with Kai Cheung Road, Lam Hing Street and Sheung Yee Road in Kowloon Bay;
  4. construction of associated footpaths, pedestrian streets, street lighting, traffic aids, drainage, sewerage, water mains, landscaping and ancillary works; and
  5. implementation of environmental mitigation measures and an environmental monitoring and audit programme for the works mentioned above.

The scope of Stage 3 comprises:

  1. construction of the following items of works located at the former south apron area –
    (i) reconstruction and widening of Shing Cheong Road and part of Cheung Yip Street from the existing single 2-lane roads to form dual 2-lane roads with a total length of about 0.7 km; and
    (ii) construction of a supporting underground structure of about 0.4 km long along Shing Cheong Road and across Cheung Yip Street as enabling works to facilitate future construction of Trunk Road T2;
  2. construction of associated footpaths, pedestrian streets, street lighting, traffic aids, drainage, sewerage, water mains, landscaping and ancillary works; and
  3. implementation of environmental mitigation measures and an environmental monitoring and audit programme for the works mentioned above.

Project Office in Civil Engineering and Development Department:

East Development Office (Enquiry: 2301 1393)

Consultant:

AECOM Asia Company Limited; and Hyder-Meinhardt-Jo

Approved Project Estimate:

$5.757 billion

Current Progress:

The Stage 2 works commenced on 30 November 2015 and the Stage 3 works commenced on 23 November 2015. The delivery of both stages of works is on schedule.

Contract:

Contract No. KL/2014/01

Scope: same as project scope for the Stage 2 above
Commencement Date: 30 November 2015
Completion Date: completion in phases between Early 2018 and 2019
Contract Sum: $1.947 billion
Contractor: CEC – CCC Joint Venture

Contract No. KL/2014/03

Scope: same as project scope for the Stage 3 above
Commencement Date: 23 November 2015
Completion Date: end 2019
Contract Sum: $2.176 billion
Contractor: China Road and Bridge Corporation

Other Related Information:

Gazette Date Subject

16 May 2014 and

23 May 2014

Scheme

16 May 2014 and

23 May 2014

Scheme

22 August 2014 and

29 August 2014

Scheme

29 August 2014 and

5 September 2014

Authorization of Scheme

29 August 2014 and

5 September 2014

Authorization of Scheme

28 November 2014 and

5 December 2014

Authorization of Scheme
